Song of Wind
RERA : PRM/KA/RERA/1251/310/PR/040924/006990
Designed for those who appreciate the charm of niche, tight-knit neighbourhoods

Awarded for Best Creative Design for Ongoing Architecture @ FOAID, New Delhi 2024
₹ 1.35 Crore* onwards
Expected Handover : January 2026
Designed for those who appreciate the charm of niche, tight-knit neighbourhoods
Address:
Banashankari 6th stage, Nagegowdanapalya, Uttarahalli -Manavarthekaval, Bengaluru, 560109
Features
- No Common Walls
- 100% Vaastu
- Exclusive 16 units of 3 BHK homes
Property Details
- Total 3 BHK Units : 16
- Size : 1691 – 1860 Sq. Ft
- Total Usable Carpet Area : 77%
- Floors No : G + 3
- Bedrooms : 3
- UDS ≈ 36%
- Facing : East or North
- Bathrooms : 3
- Balconies : 3
Amenities
- Multipurpose Hall
- Fully Equipped Gym
- Spacious Sky Lounge
- Children’s Play Area
- Library
- Yoga area
- Senior Citizen Park
- 100% Power Backup
Fixtures
Fixtures
- Main door : Burma / Ghana Teak wood
- Bathroom Fixtures : Kohler or Equivalent
- Tiles : Kajeria or Equivalent
- Switches : Schneider Unica or Equivalent
- Master Bedroom : Wooden Flooring
- Lifts : Johnson or Equivalent
Location Advantage
- Silk Institute Metro Station : 5 mins
- Nice Road : 6 mins
- Electronic City : 30 mins
- Forum Mall : 15 Mins
- ISCKON Temple : 17 Mins
- Art of Living International Centre : 10 Mins
- Metro Cash and Carry : 20 Mins
- Manipal Hospital : 20 Mins
- Holiday Village Resort : 15 mins
- Sri Kumaran School : 16 mins
- Delhi Public School : 22 mins
- Valiants Academy Campus : 11 mins
Project Status
Mar
2024
Sep
2024
Mar
2025
Sep
2025
Feb
2026
Current Completion : 93%
Status as of 10th Feb 2026 : Internal plastering and External plastering completed (100%)
Vitrified flooring and Toilets Tiling Completed (100%)
Putty work completed (100%)
Elevation cladding completed (100%)
Basement plastering abs painting completed (100%)
Windows fixing completed (100%)
Grills fixing completed (100%)
Door fixing completed (100%)
Staircase railings fabrication completed (100%)
Granite work completed (100%)
External texture and Dampproof completed (100%)
Basement flooring concrete and Ramp completed (100%)
Compound wall blockwork and plastering completed (Left side)(35%)
Terrace waterproofing and concrete completed (100%)
Lift installation completed(95%)

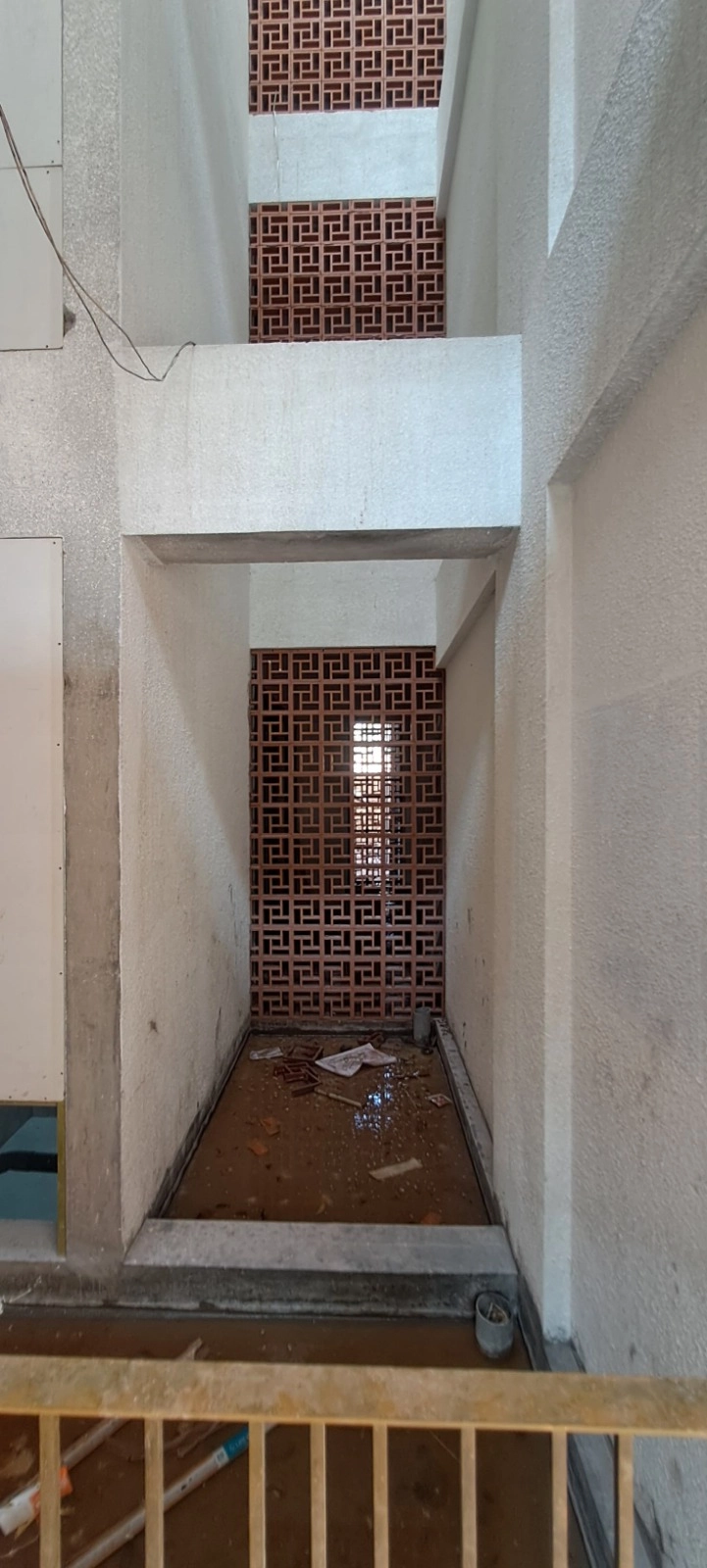

Elevation Jalli work InProgress (70%)
Internal Final painting work InProgress(20%)
Status as of 10th Feb 2026 : Internal plastering and External plastering completed (100%)
Vitrified flooring and Toilets Tiling Completed (100%)
Putty work completed (100%)
Elevation cladding completed (100%)
Basement plastering abs painting completed (100%)
Windows fixing completed (100%)
Grills fixing completed (100%)

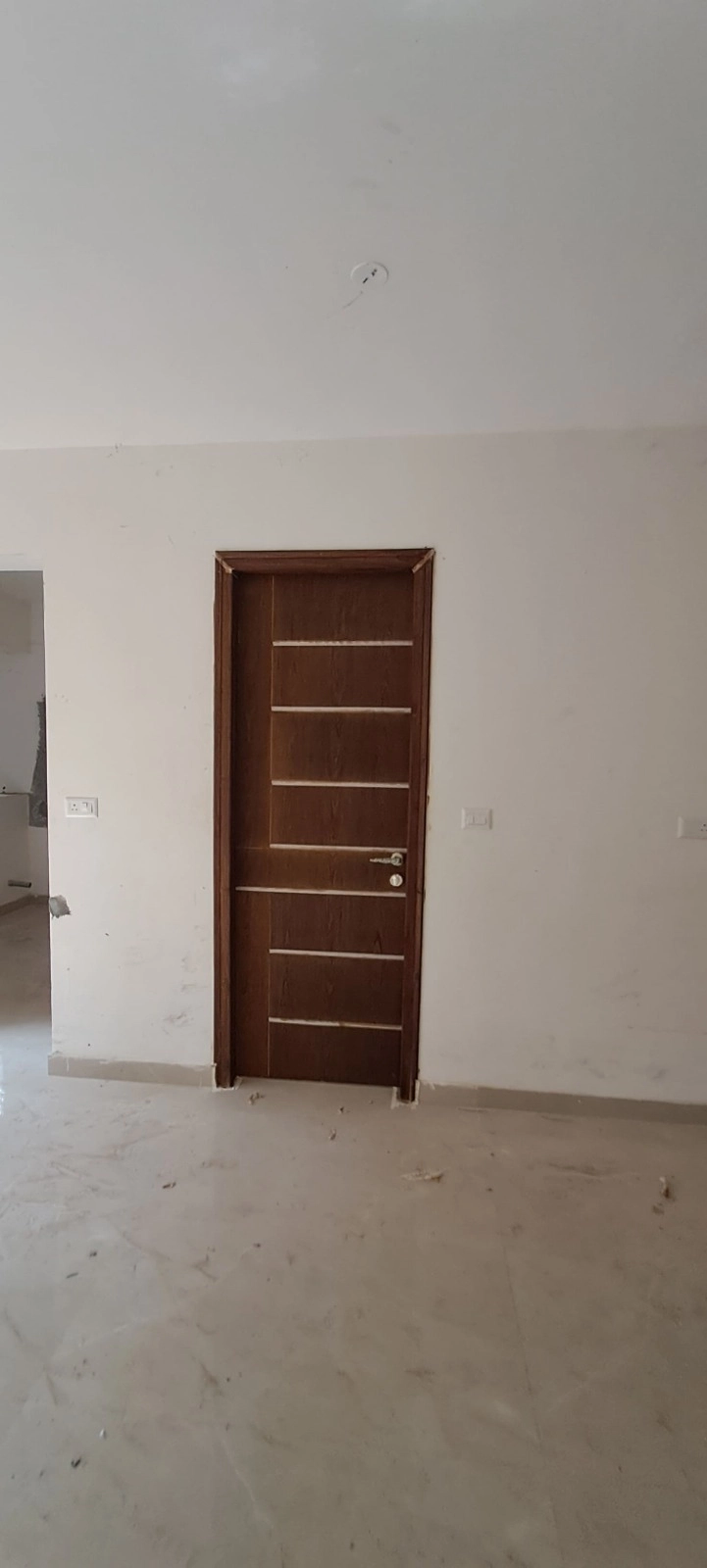

Door fixing completed (100%)
Staircase railings fabrication completed (100%)
Granite work completed (100%)
External texture and Dampproof completed (100%)
Basement flooring concrete and Ramp completed (100%)
Compound wall blockwork and plastering completed (Left side)(35%)
Terrace waterproofing and concrete completed (100%)
Lift installation completed(95%)
Elevation Jalli work InProgress (70%)
Internal Final painting work InProgress(20%)
Project Status : Right On Schedule
Next Update on 10th Mar 2026
Next Update on 10th Mar 2026

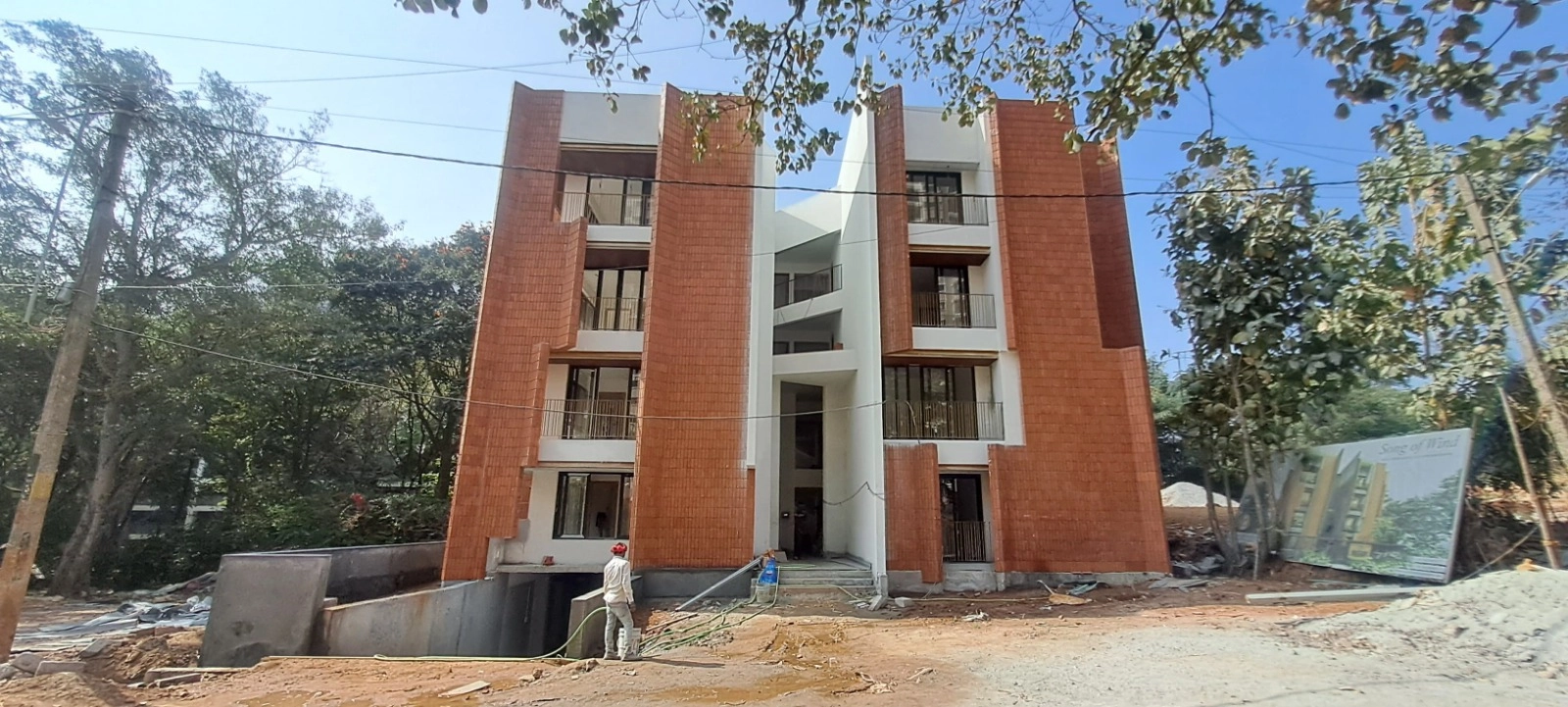

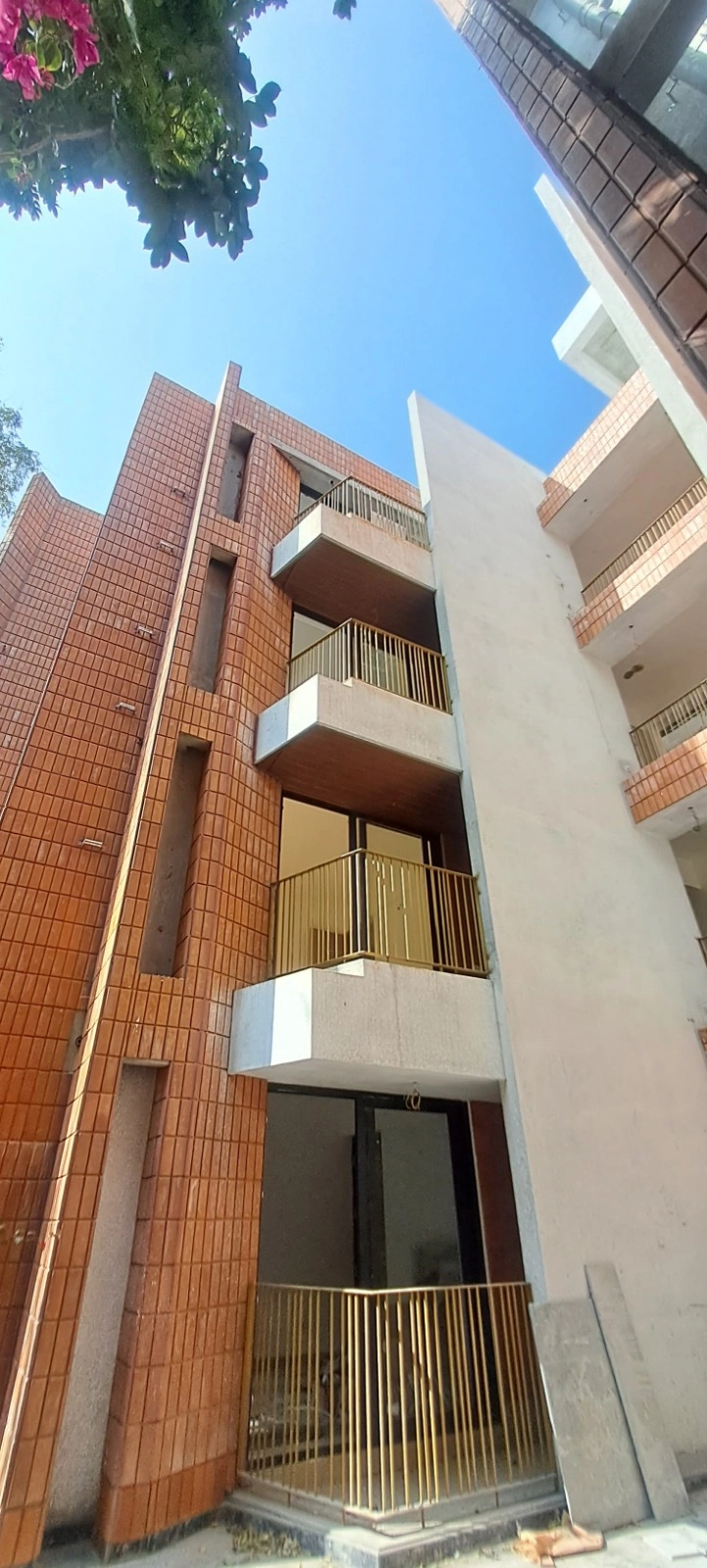

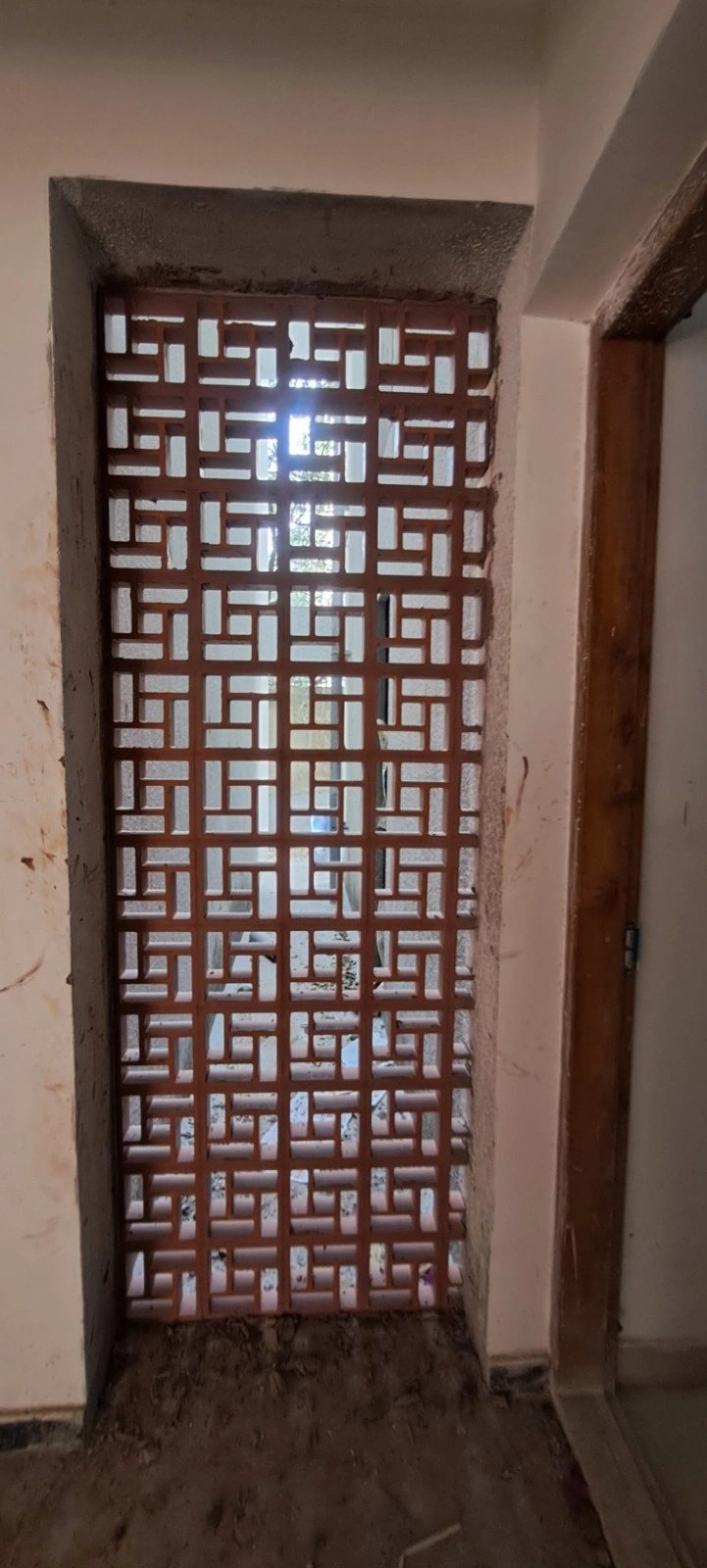

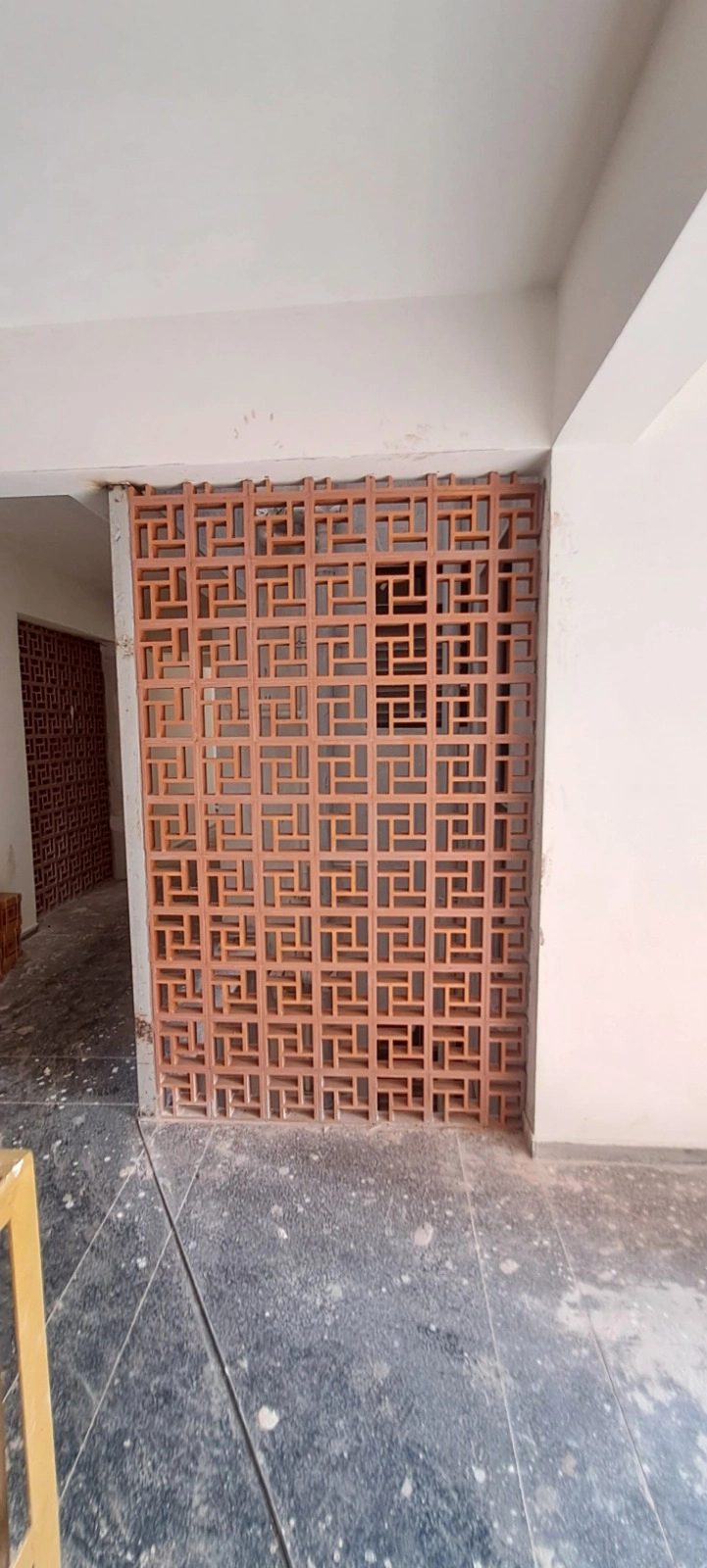

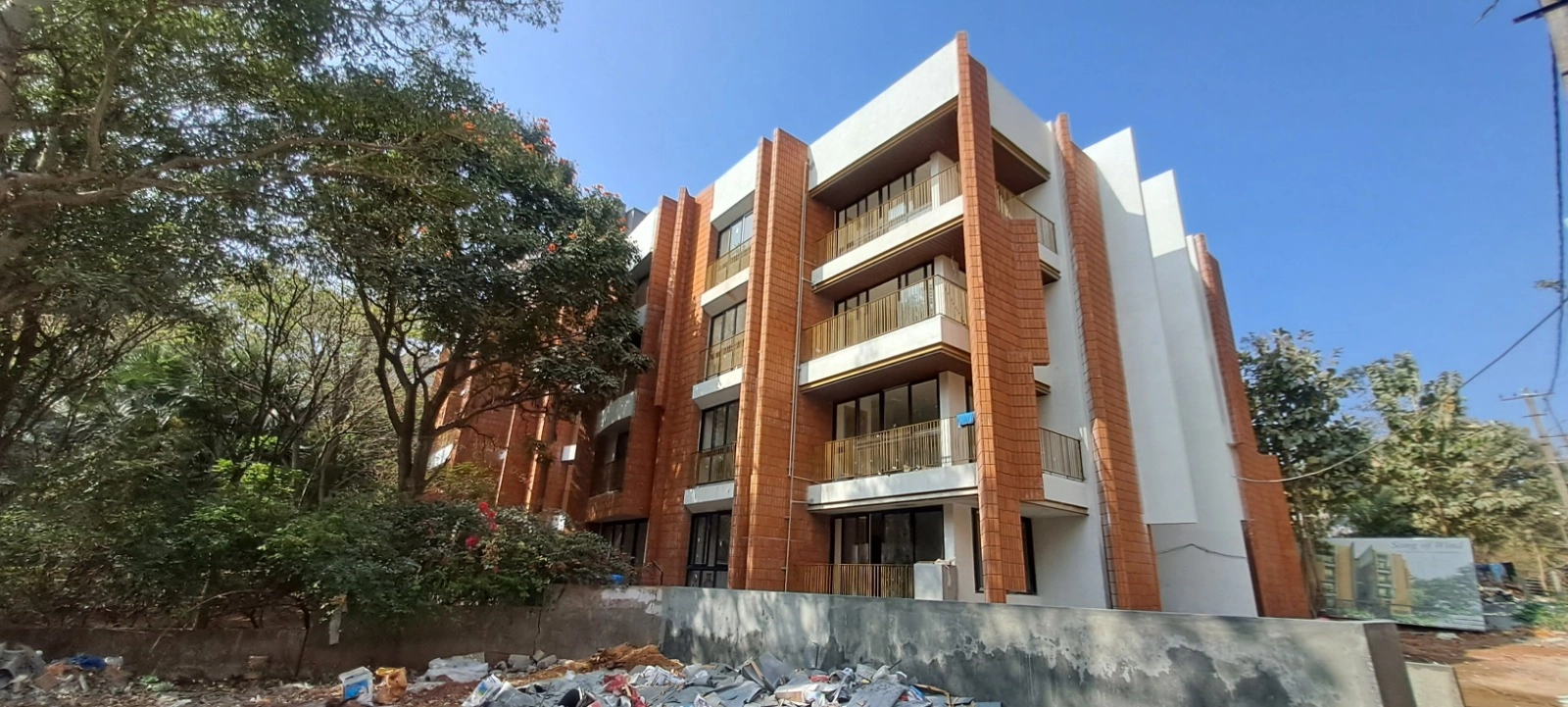

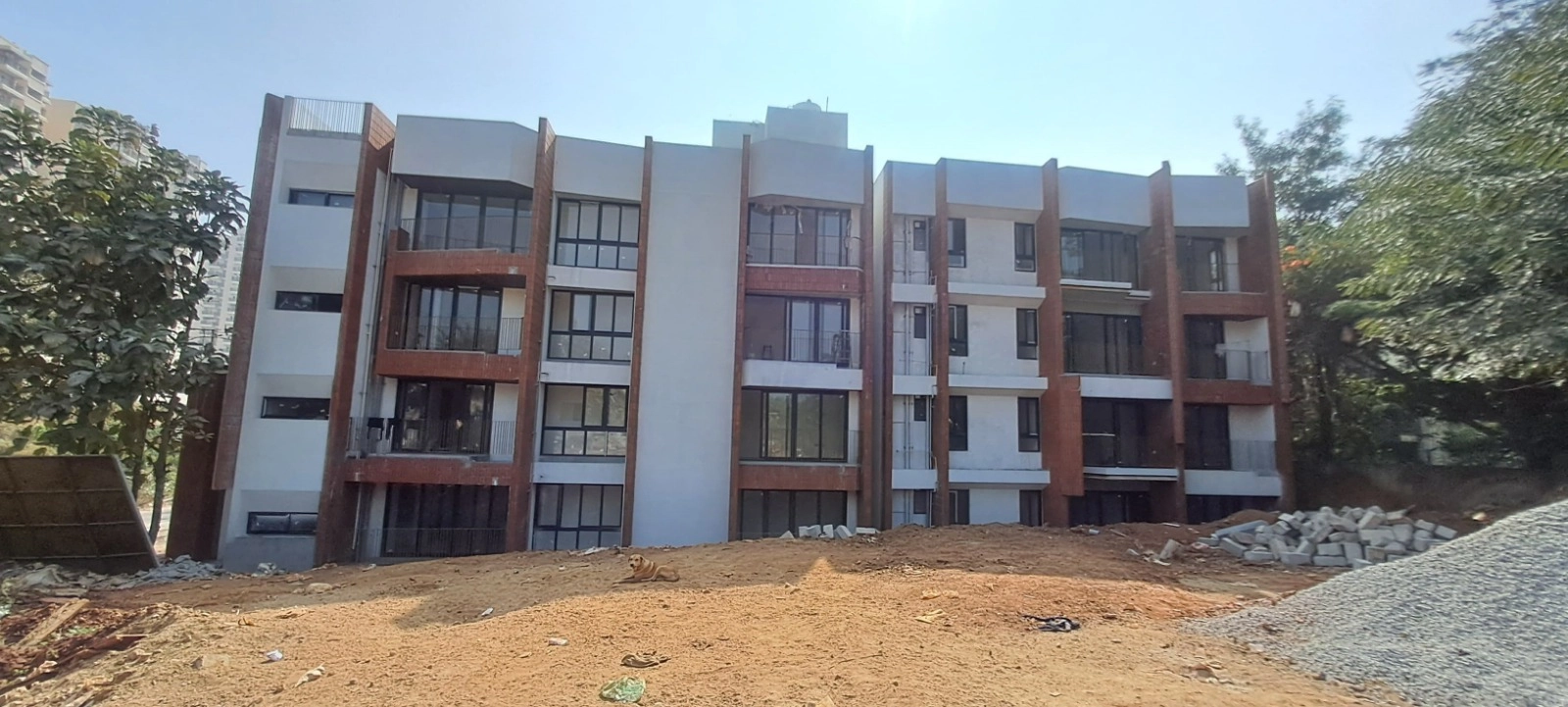

Current Status
